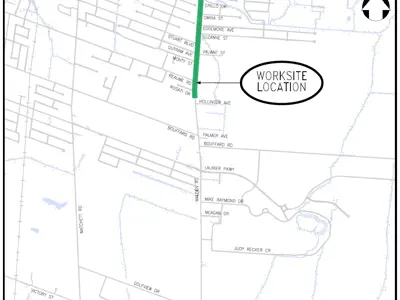

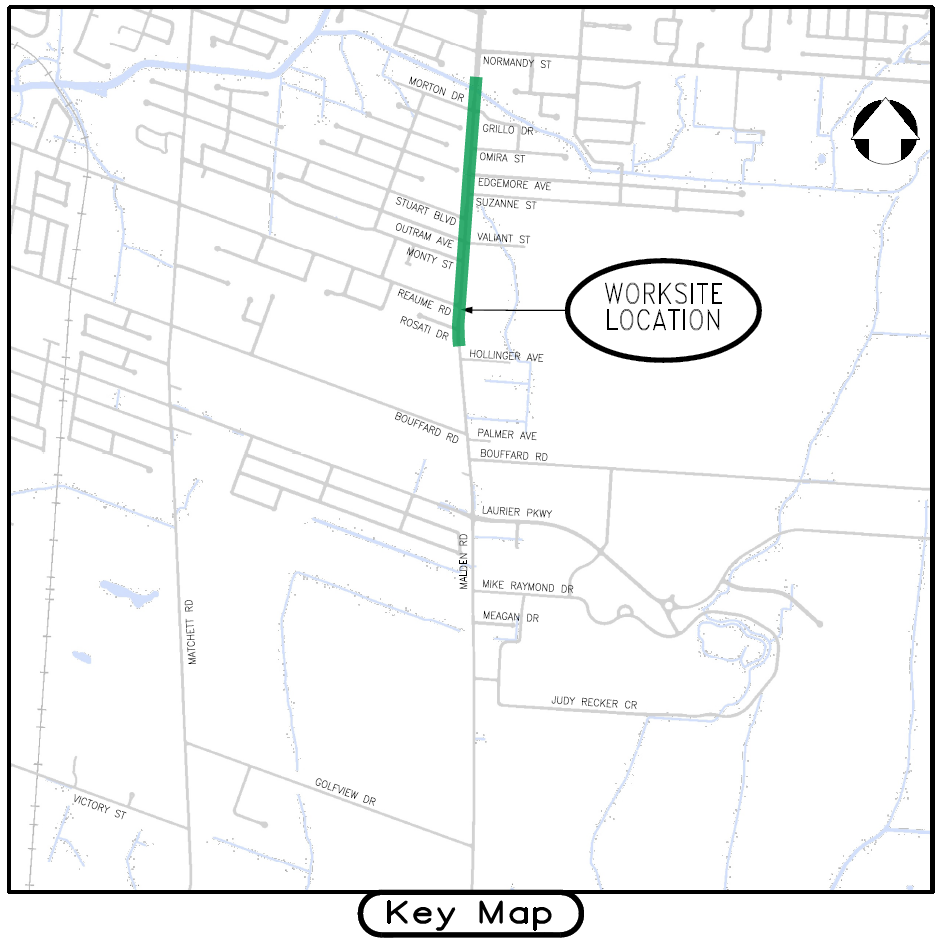

Malden Road Phase 1 Reconstruction
The Malden Road Phase 1 Reconstruction project is currently in the detailed design stage and will be tendered at the end of 2026. Below is an overview of the project:
Project Information:
- Two lanes of traffic widening to three lanes on Malden Road (center turning lane added as per EA).
- Addition of bike lanes, sidewalks and trails on both sides of the road.
- New signal light at the Malden - Reaume Road intersection.
- Additional pedestrian crossovers (PXOs) within the corridor.
Project Schedule:
- November 2025 to Spring 2026 - Enbridge will begin relocating the gas utilities, including private service connections.
- Spring/Summer 2026 - Communication and powerline utility construction to being. Other works will include bridge reconstruction at the Cahill Drain, and minor watermain works in the associated area.
- Fall 2027 - Utility and preconstruction works to be completed. Remaining works to be tendered.
- March 2027 - Main construction to begin and should last until December 2027.
For background information related to this project visit the Malden Road EA web page.
